Dak Nong Wind Power
Goals & Scope of Work
Dak N’Drung 1, 2 & 3 wind power projects in the Central Highlands

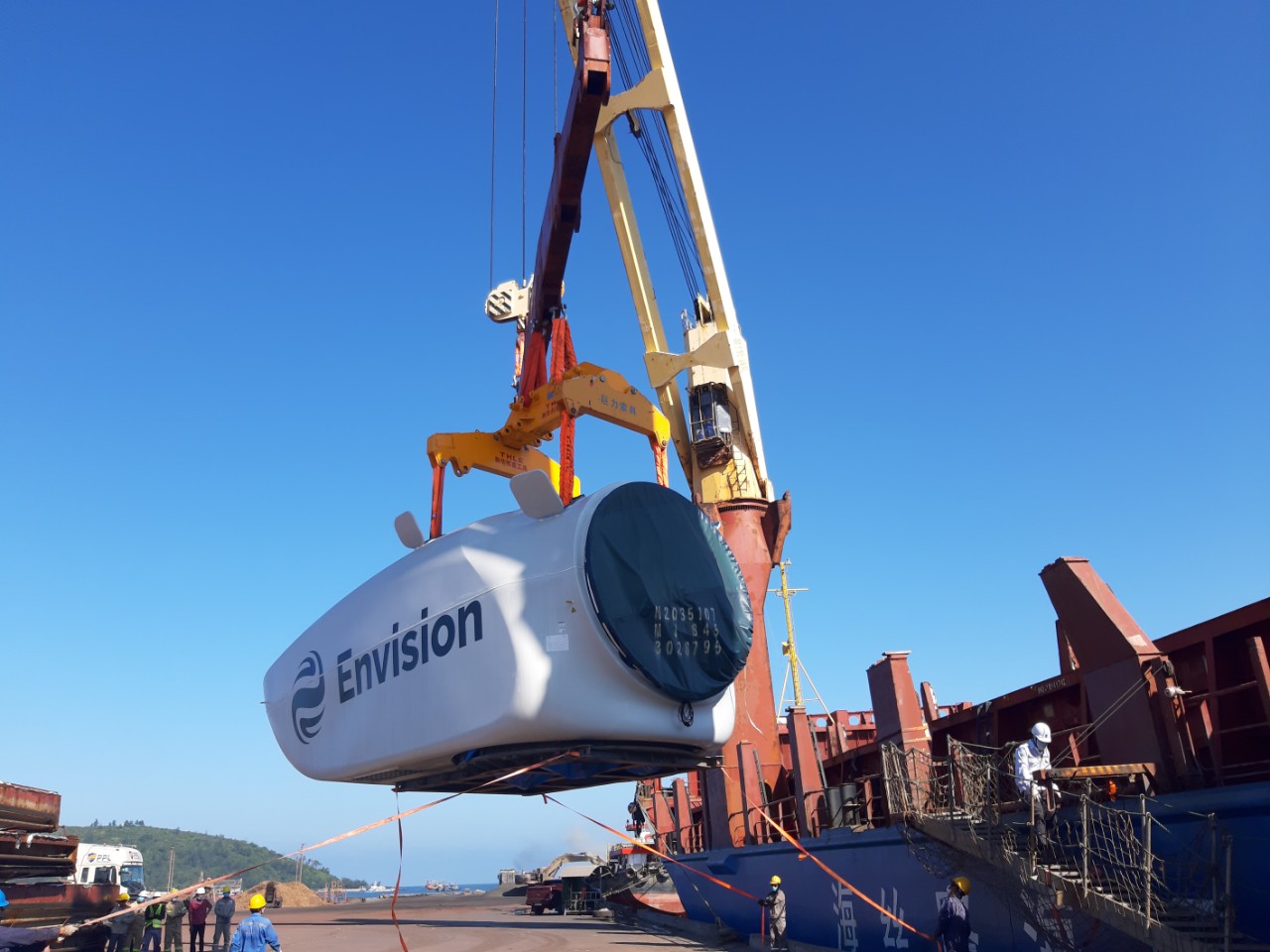

PPL transported 81 wind power equipment sets (tower, blade, nacelle) from Phu My Port and Cam Ranh ports to the site
Ensured on-schedule delivery in compliance with international safety standards
Key Challenges
Heavy & oversized components (up to 107 tons, 75.7 m length)
Long transport distance (~620 km) from port to site
Mountainous terrain with complex route conditions, weather, and traffic impacts along the corridor
The quaratine time of COVID-19
Solutions & Deployment
Mobilized specialized transport fleet imported from Europe
Developed dedicated transport plans for each oversized component
Executed port handling and route-based delivery strategy
Maintained strict HSE and operational control throughout
Deployed experienced teams for real-time coordination and issue handling
Project Overview
Project owner
Sungrow Power Supply Co., Ltd.
Contractor
Sungrow Power Supply Co., Ltd.
Direct client
Sinovitrans Logistics Co., Ltd.
Scope of work
Port handling and transportation
Cargo volume
81 turbines
Cargo weight (MT)
107
Most oversized cargo item
75.7 m
Project location
620 km (From Phu My Port to construction site: 338 kmFrom Cam Ranh Port to construction site: 275 km)
Execution period
March 2021
